Phasing

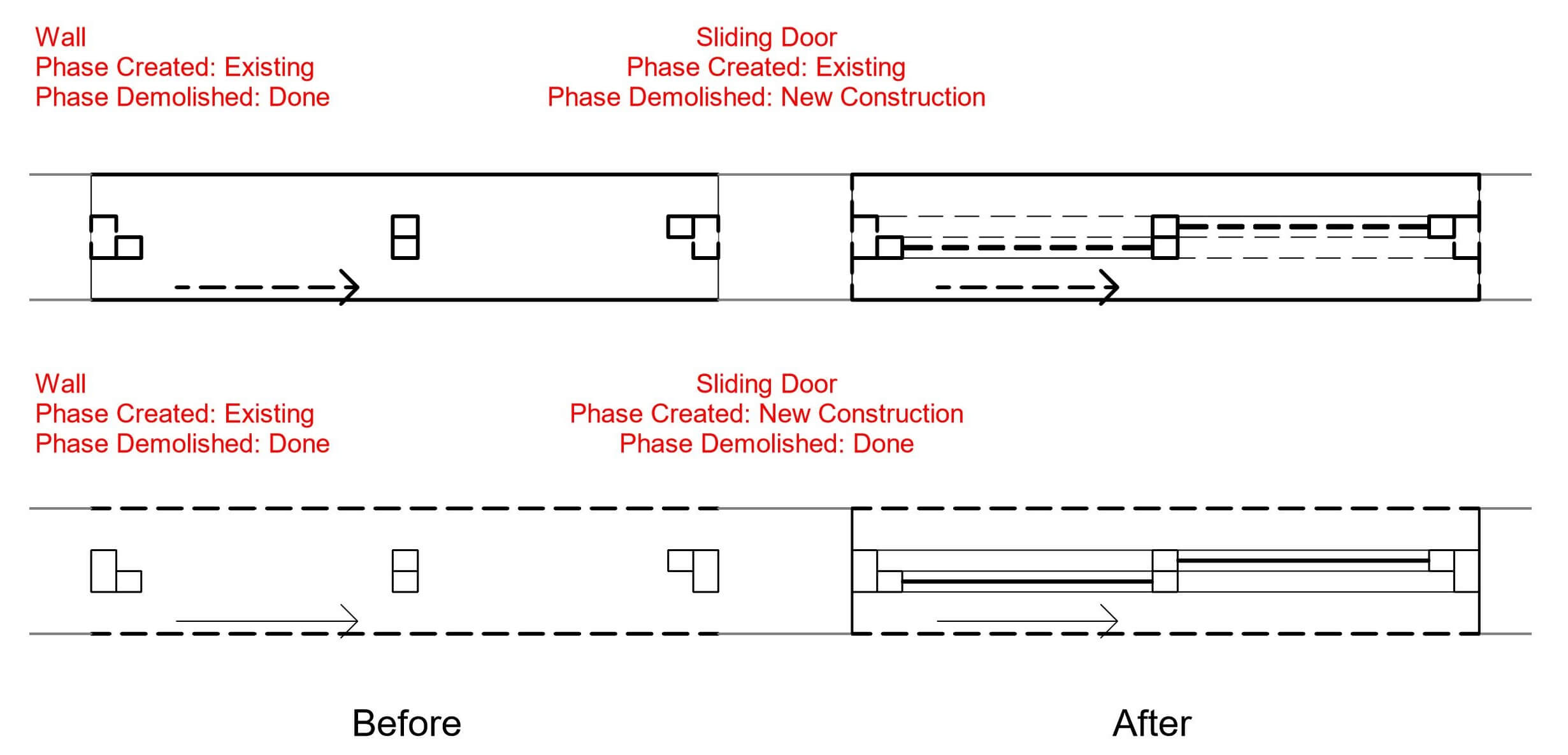

We've fixed an issue where lines for frame and panels were hidden when host wall has "Phase Created: Existing".
Instead of the simple opening tool, this family uses various voids for the wall opening, to provide features like rough distance, render offsets, and taper reveals. This causes issues in the following scenarios:
- When placing the same door (copied instance or newly loaded) in the exact same place with different creation and demolition phases.
- When wall opening lines are hidden and host wall has "Phase Created: Existing", and door has "Phase Created: New Construction" (usually used in renovation).

Note: Solutions for these scenarios described in manual.
Shared Parameters
We've renamed and add some shared parameters that makes it a consistent format with other our families.
Renamed parameters:
| Previous | New | Type |
|---|---|---|
| Glass Area With Glazing Bar | .Glass Area With Glazing Bar | Area |
| Glass Area Without Glazing Bar | .Glass Area Without Glazing Bar | Area |
| Opening Area | .Opening Area | Area |
| Panel Double Glazing | .Panel Double Glazing | Yes/No |
Added parameters:
| New | Type |
|---|---|
| .Door Panel Thickness | Length |
| .Frame Depth | Length |
| .Rough Height | Length |
| .Rough Width | Length |
Constraint errors
We've fixed an issues related to panel constraints, resolving a warning when panel count in range 1-5 and an error when panel count equals 10.
Revit version
Version 2.1 supports now all Revit & Revit LT versions from 2020.
